Project in Chelsea, Manhattan

An office move in Chelsea, with the network running before the movers

A tech company’s 45-desk New York office moved two blocks to a renovated floor. We reused the last tenant’s cable and built the network in one day, before the movers.

Book a call Get an assessment
Chelsea, Manhattan January 2026 (914) 714-4312
The move

The movers were booked and the floor was still closed

The office manager reached us through a referral, about two months before the move. The team, about 40 people and growing toward 60, was moving two blocks to a renovated floor in Chelsea. Their IT manager is based overseas.

“Move in date is Jan. 15th and we would need everything up and running by then.”

The office manager, November 2025

Building management closed the floor for new flooring until a few working days before the movers.

The walkthrough

A video call found cable we could reuse

The office manager walked the floor with us over FaceTime. The last tenant had left 17 cable runs in place, including six ceiling cables where its access points had hung.

Reusing them meant no new cable or ceiling work. The network design and the estimate went out that afternoon.

Three weeks later the IT manager approved the network plus the desk setups and three Zoom Rooms, one moved from the old office and two new.

What we installed

One rack, six access points, every run labeled

  • UniFi Dream Machine Pro gateway, the main router
  • UniFi Pro Max 24 PoE switch, which also powers the access points
  • Six U7 Pro XG Wi-Fi 7 access points on the existing ceiling cables
  • Rackmount battery backup
  • Every cable tested and labeled: six for access points, ten data cables

The switch we planned on was out of stock until February, so we moved up to the Pro Max 24 PoE to keep the date.

Install day

On site at 10, done by early afternoon

On install day we were on site from about 10 to 2. The internet provider installed its fiber line that same day.

We set up the router, switch, access points and battery backup, tested and labeled every cable, and put staff and guests on separate networks.

By early afternoon the network was set up and tested, three days before the movers. We handed ownership of the network to the IT manager and stayed on as an admin while the office settled in.

Empty renovated office floor with a glass partition and wood floors
The renovated floor on install day.

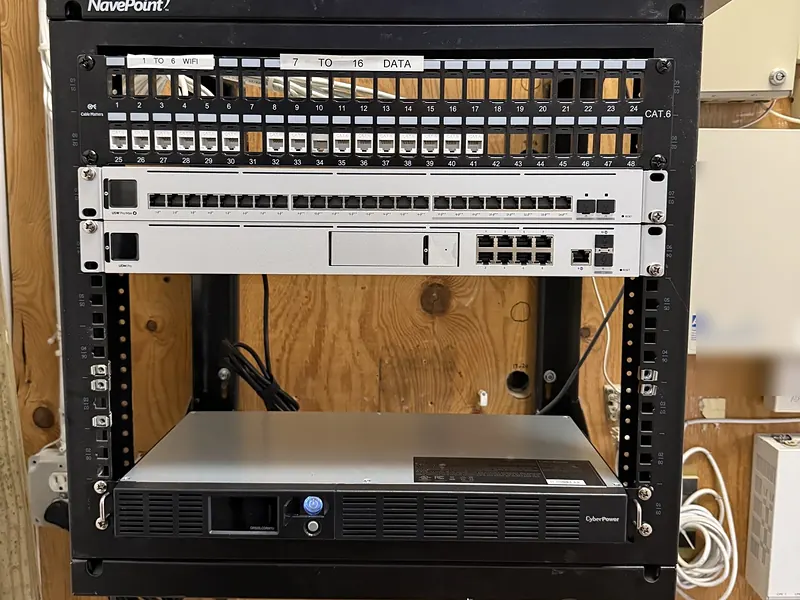

Wall rack with a patch panel, UniFi PoE switch, UniFi gateway and battery backup
The new equipment in the wall rack on install day.
Move-in week

Then the desks and the meeting rooms

Desks and monitors arrived with the movers three days later. The office wanted everything ready for a company event:

“…the 19th is a little late for workstation setups because everyone is coming in on the 20th for an event in the new space”

The office manager, December 2025

So we came back that Friday. By the end of that day most of the roughly 45 workstations were connected and the meeting rooms were ready.

A late request added an 85-inch screen with a camera for all-hands meetings. We finished it and the last three desks on Monday, the day before the event. Everything was handed off that week.

After the move the office asked us back about sound for all-hands meetings in the open space. Before an important meeting in late April we set up a temporary laptop and speaker. A permanent system is still being planned.

Related: Build-Outs & Moves, Business Networking & Wi-Fi, Office move IT, New York City

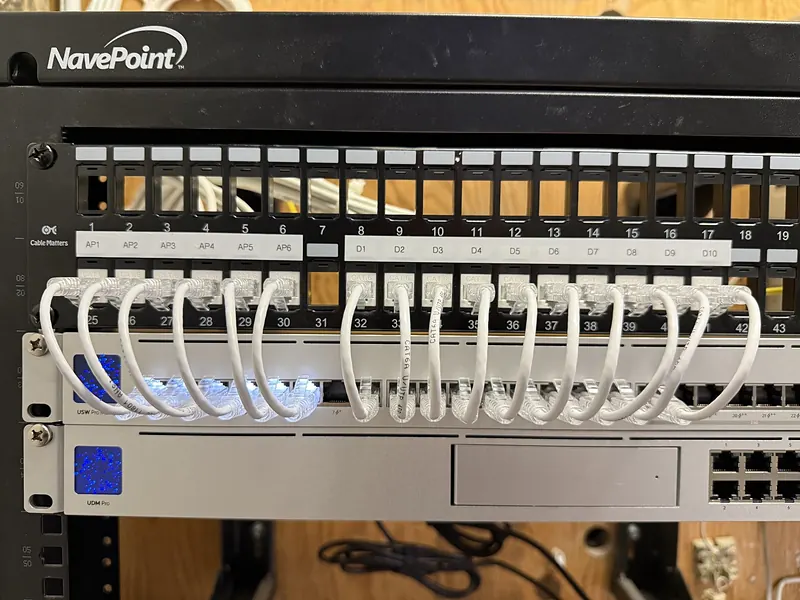

Patch panel labeled AP1 to AP6 and D1 to D10 with short white patch cables into a UniFi switch
Every cable tested and labeled.
Open office floor with desks and chairs during move-in week
Move-in week, with desks going back together.
